Knaphill, Woking ยท Modular development

Knaphill for Mears.

Twelve apartments built off site as sixteen factory modules, craned into place in three days, then finished on site. Delivered for a national housebuilder.

The project

A development of twelve new apartments in Knaphill, Woking, delivered for national housebuilder Mears. Rather than build in the usual way, the homes were manufactured off site as sixteen volumetric modules, transported by road, craned into position and fitted out on site.

Project facts

LocationKnaphill, Woking
ClientMears (national housebuilder)
TypeModular development
Homes12 apartments
Modules16 factory-built pods
RoleMain contractor
InstallCraned in over 3 days
Discuss a project like this
The finished Knaphill apartments from the street A module being craned into place at Knaphill

Built in a factory, not on the street

Modular, or volumetric, construction means building the home as finished three-dimensional units in a factory, then assembling them on site. For Knaphill, sixteen modules were manufactured under cover in North Yorkshire while we prepared the site in Surrey, so two big phases of the job ran at the same time rather than one after the other.

How it came together

From factory floor to finished flats.

As main contractor we coordinated the whole programme: the factory build, the groundworks, the crane lift and the full internal fit-out on a tight residential site.

1. Groundworks, while the modules were being built

On a constrained urban plot, we cleared the site and formed the foundations and services the modules would sit on. This happened in parallel with manufacture: while our team prepared the ground in Knaphill, the sixteen modules were being built in the factory around 250 miles away, roughly eight weeks of controlled, weather-independent work.

Groundworks on the tight urban site

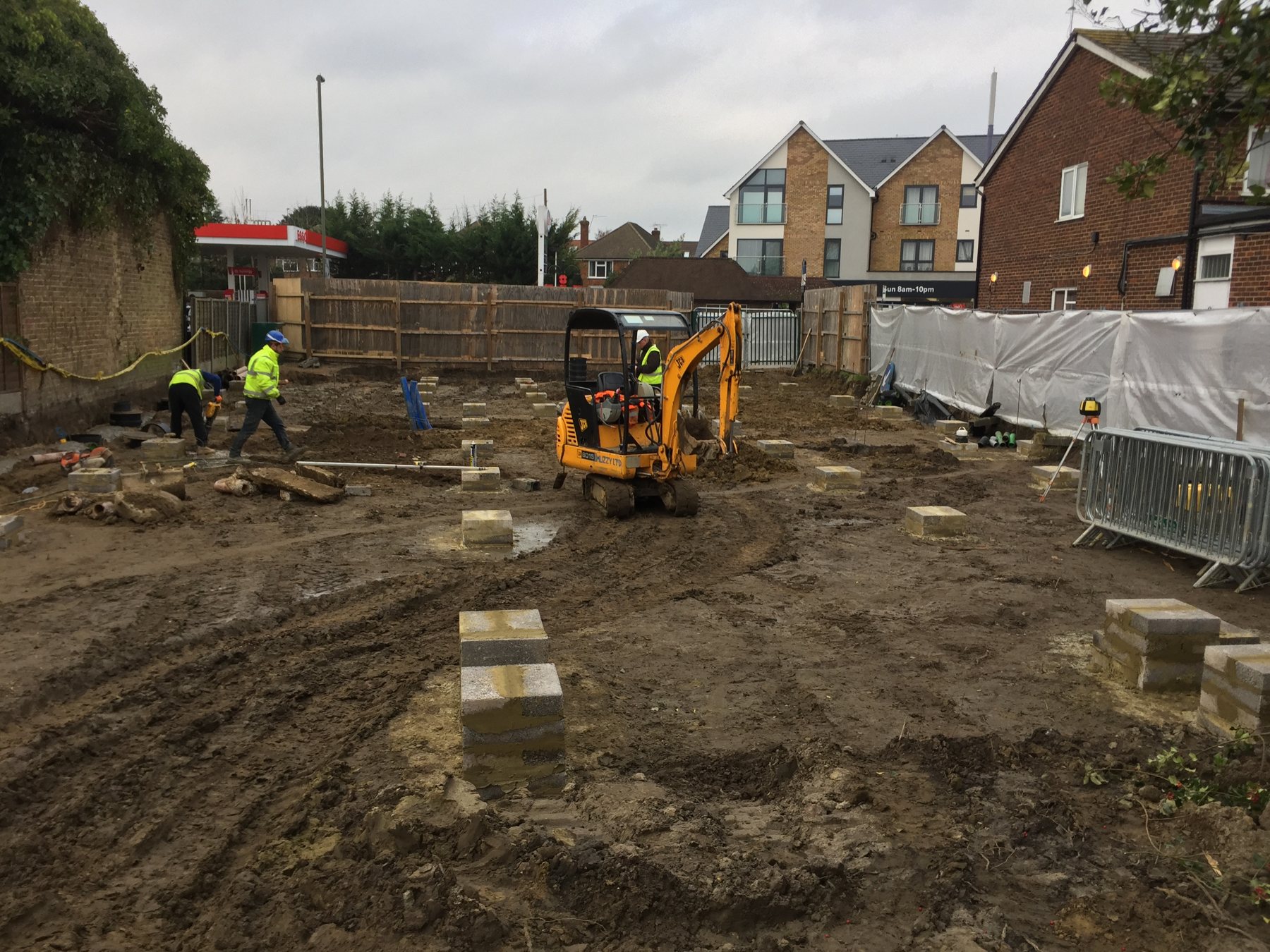

Clearing the site

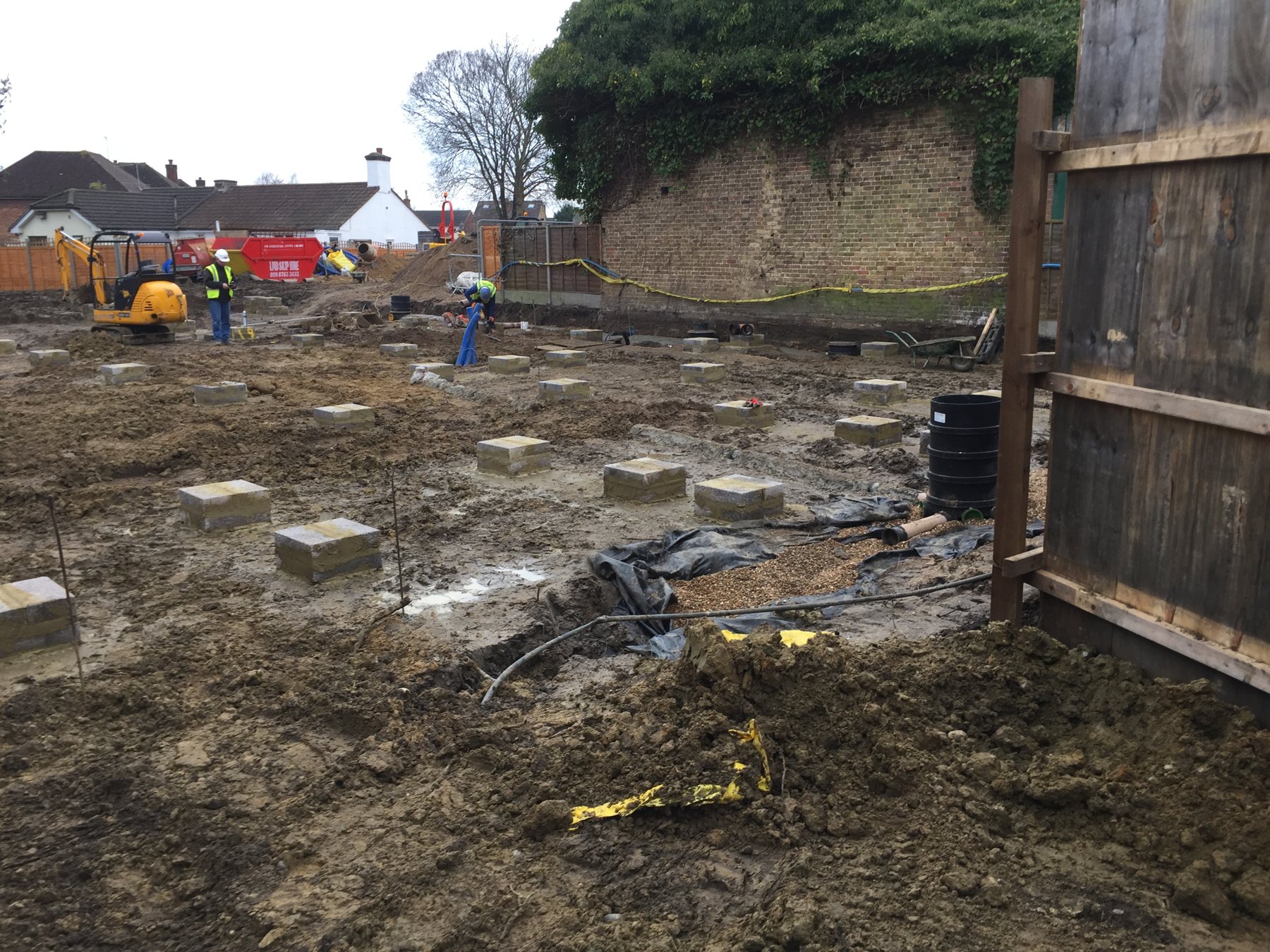

Foundation pads set out for the modules
Foundations for the modules
The Knaphill site on a residential street
A tight residential plot

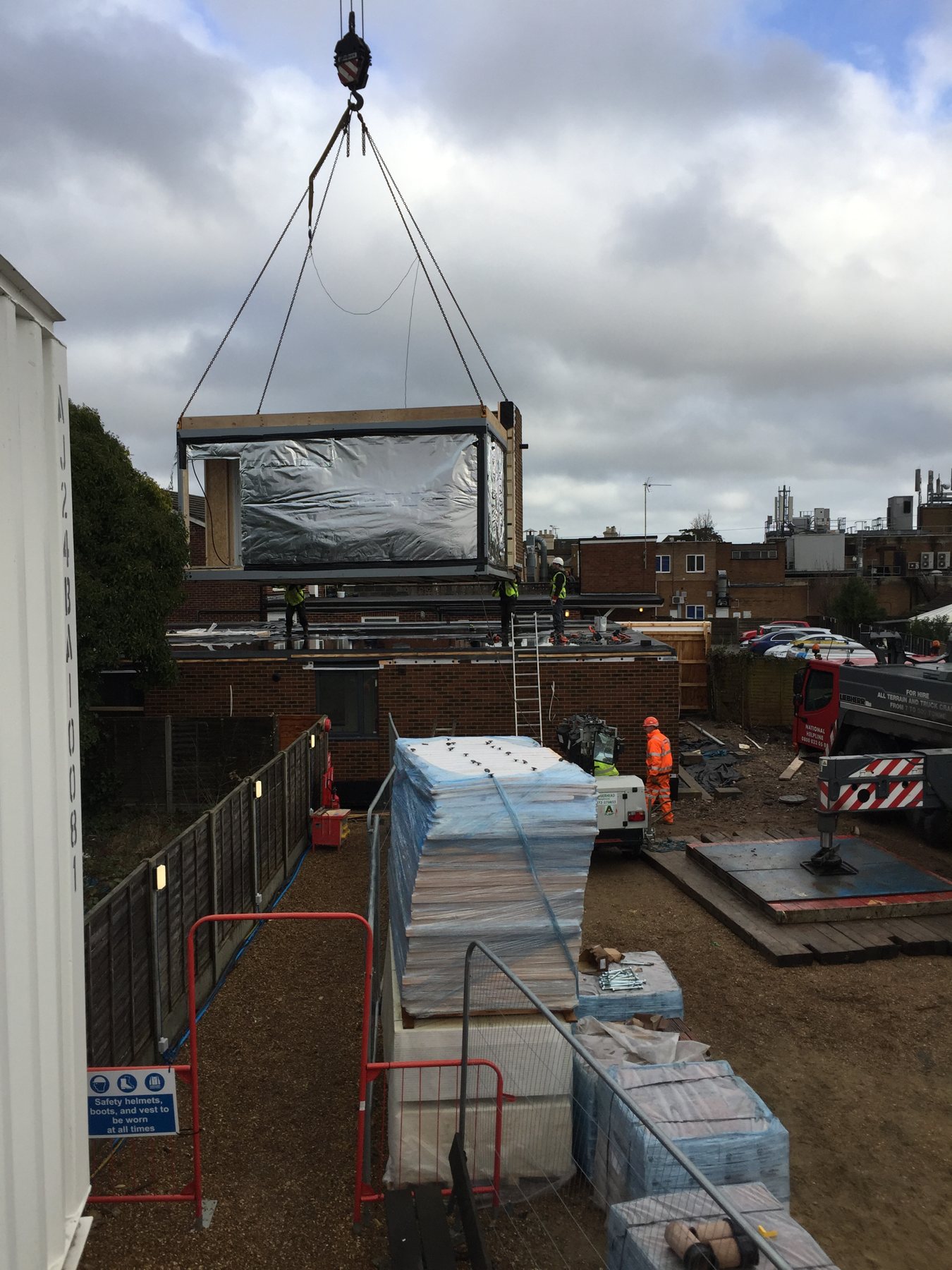

2. Delivered by road and craned in over three days

The finished modules were wrapped and transported by road from North Yorkshire to Surrey, then lifted into position by mobile crane. Sequenced carefully around the street and neighbours, the entire structure, all sixteen pods forming twelve homes, was craned into place and connected in just three days.

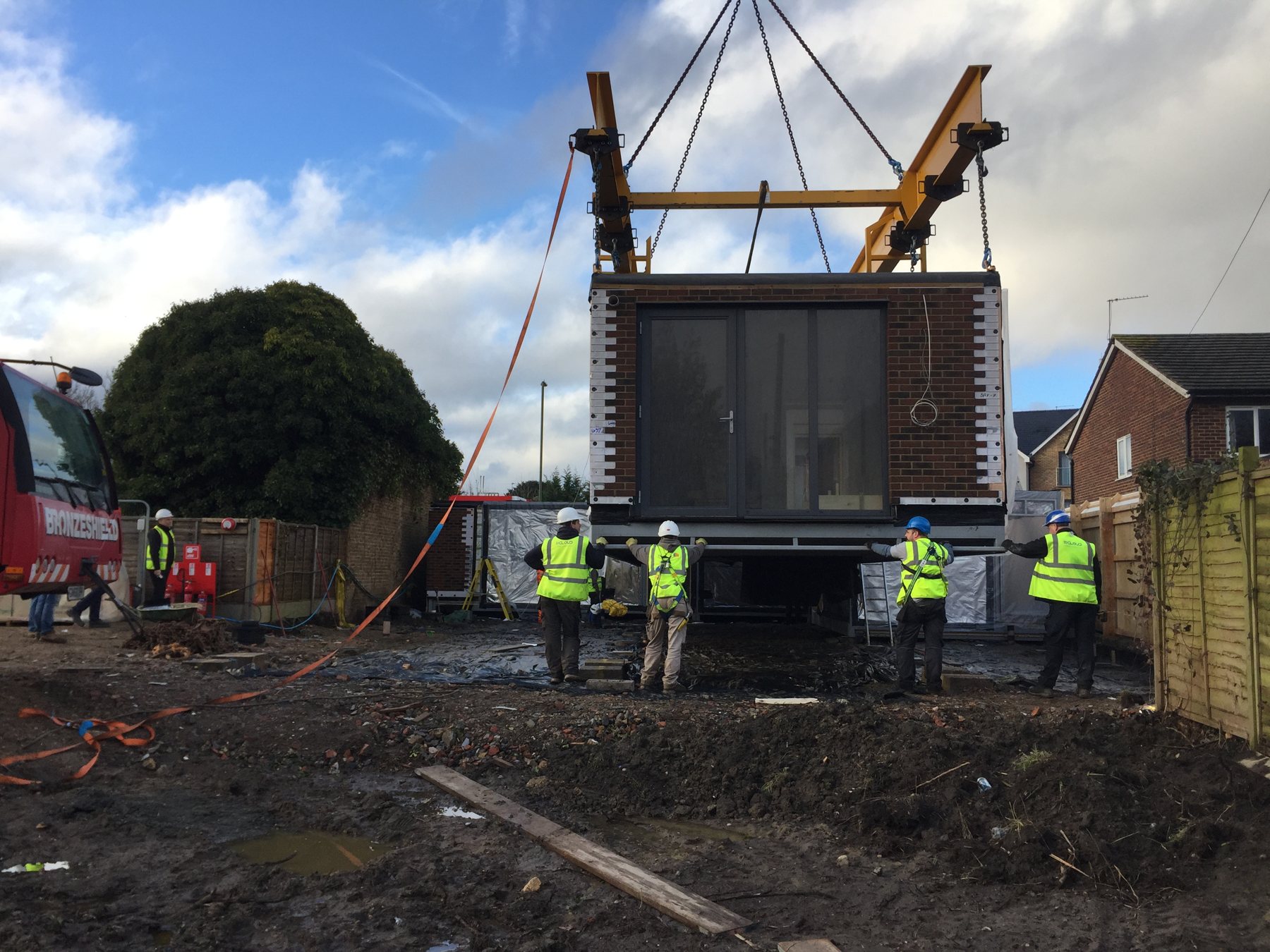

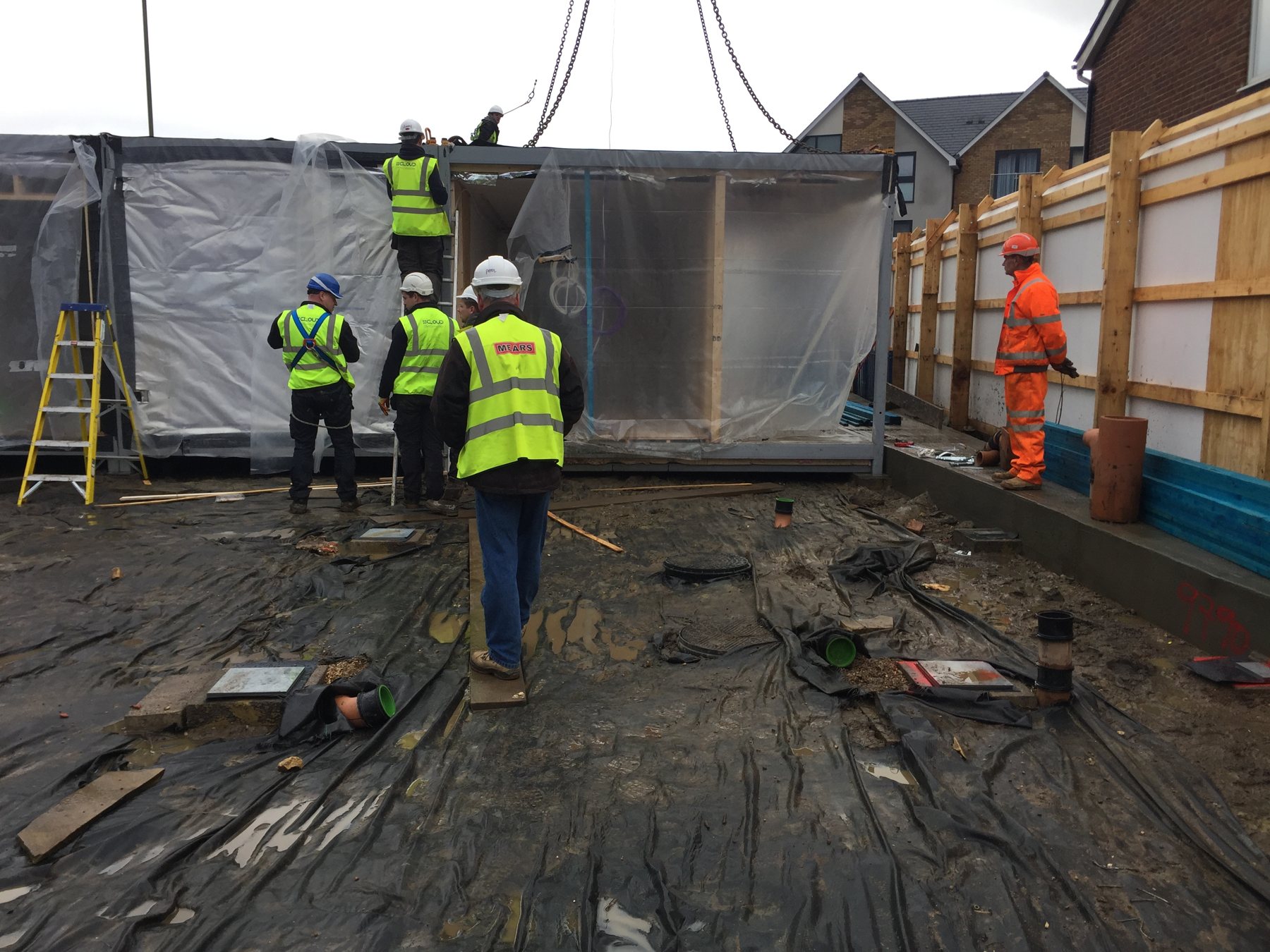

A module on the crane slings
Lifting a pod

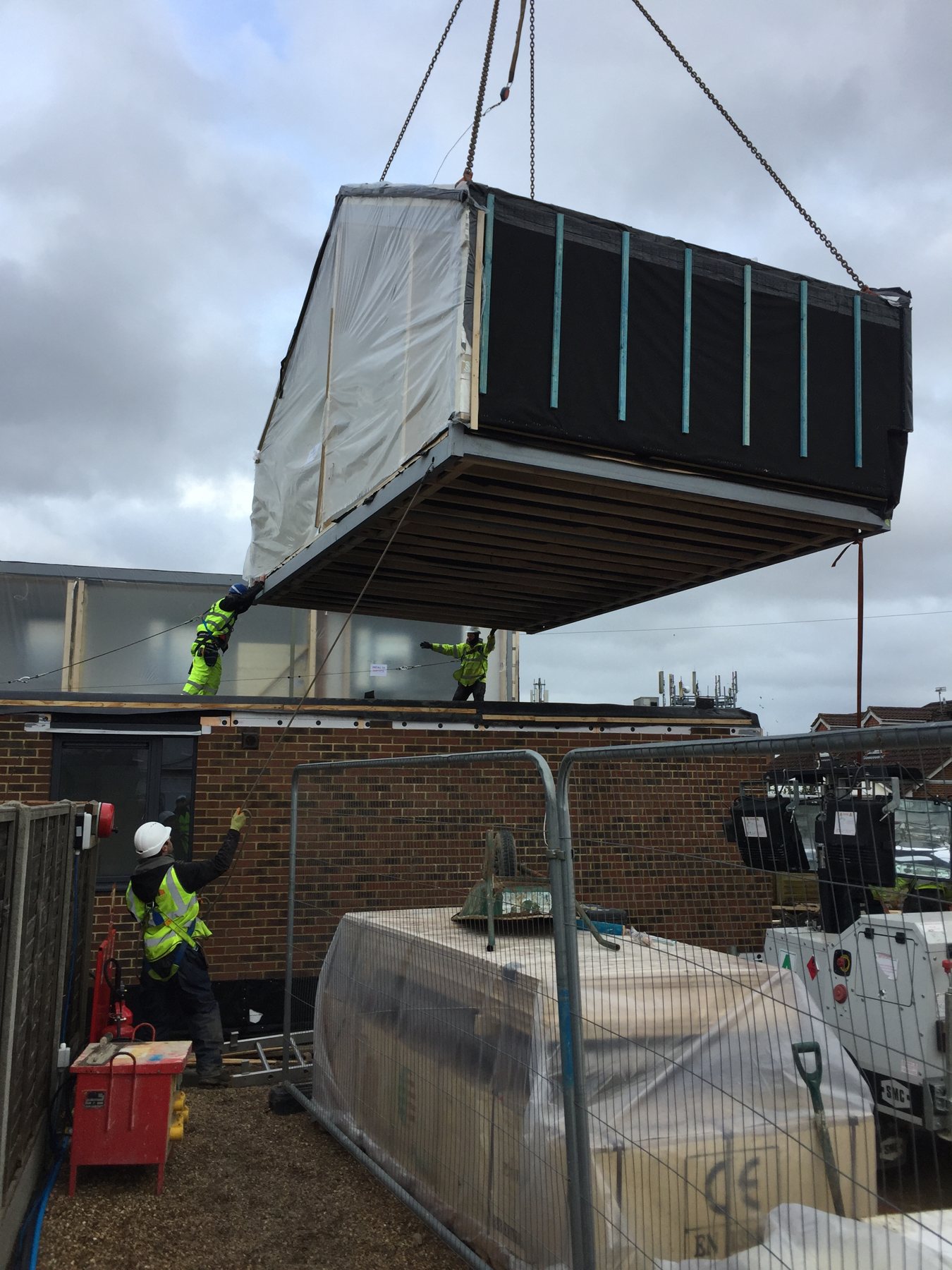

A module craned over the site
Into position

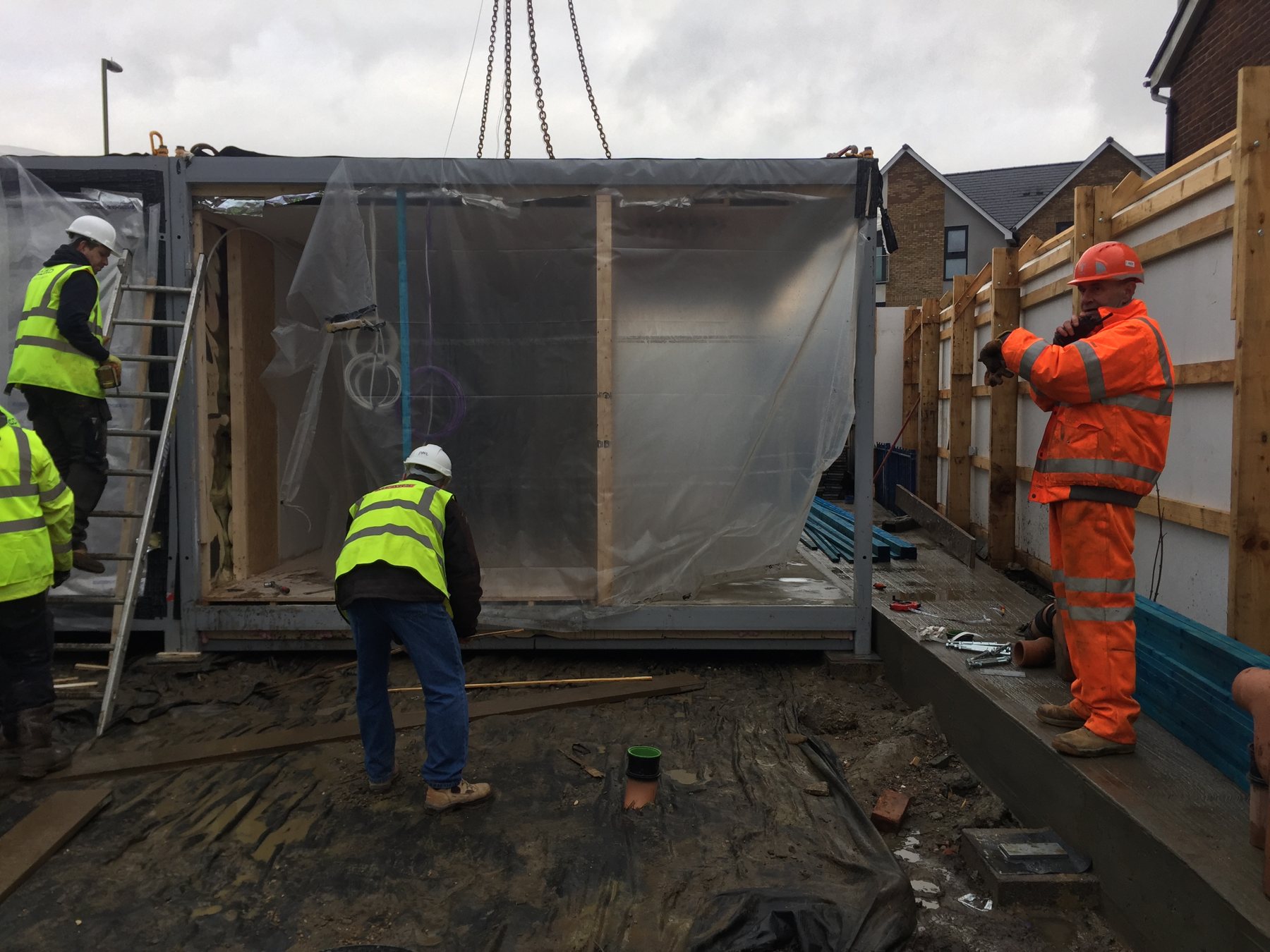

The team installing and connecting modules
Landing and connecting
Positioning a module by hand
Aligning the pods

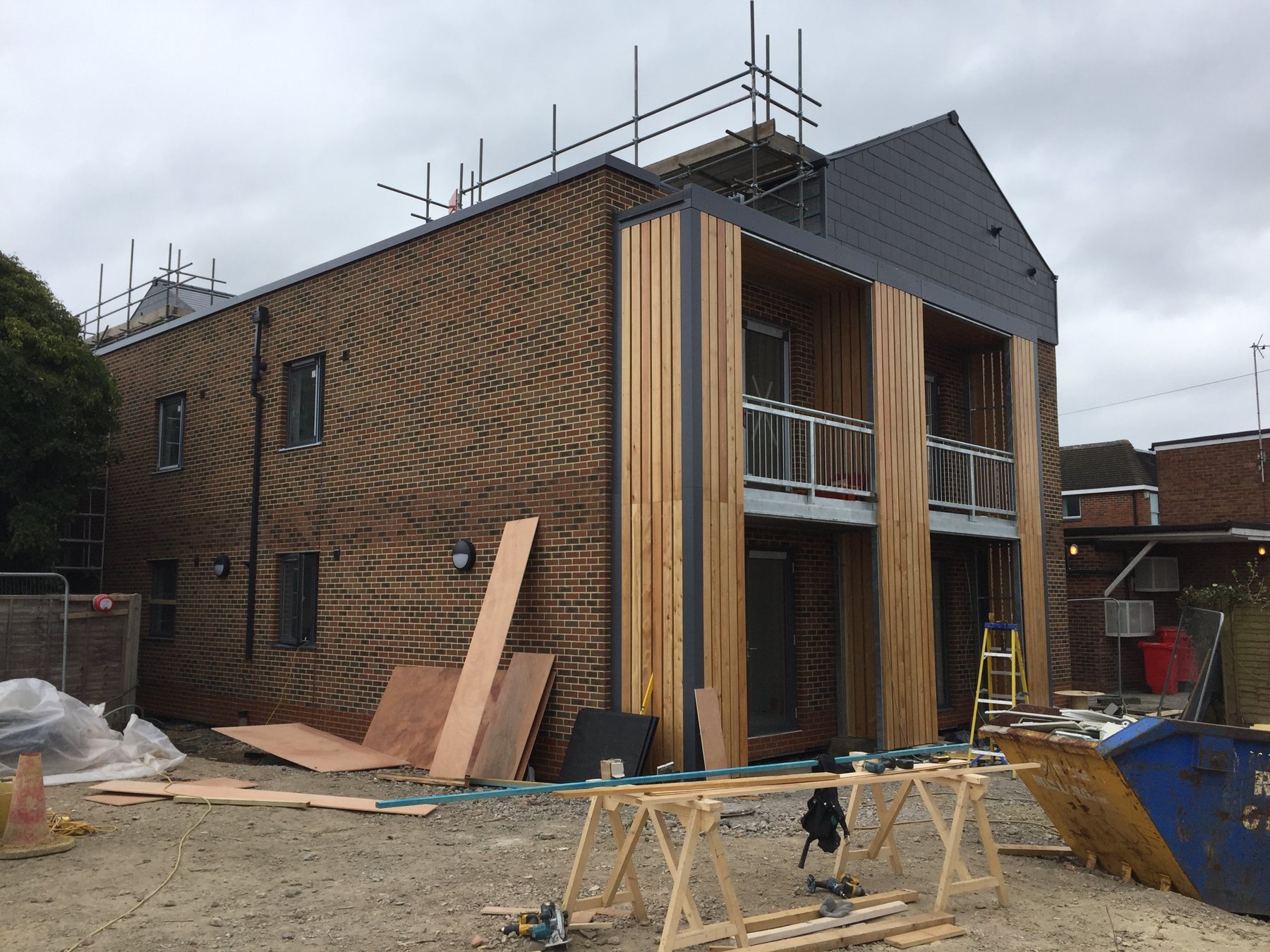

3. Finished and fitted out on site

With the structure up and weathertight, the team moved inside for around eight weeks to stitch the modules together and complete the internals: kitchens, bathrooms, services, finishes and the shared areas, ready for residents to move in.

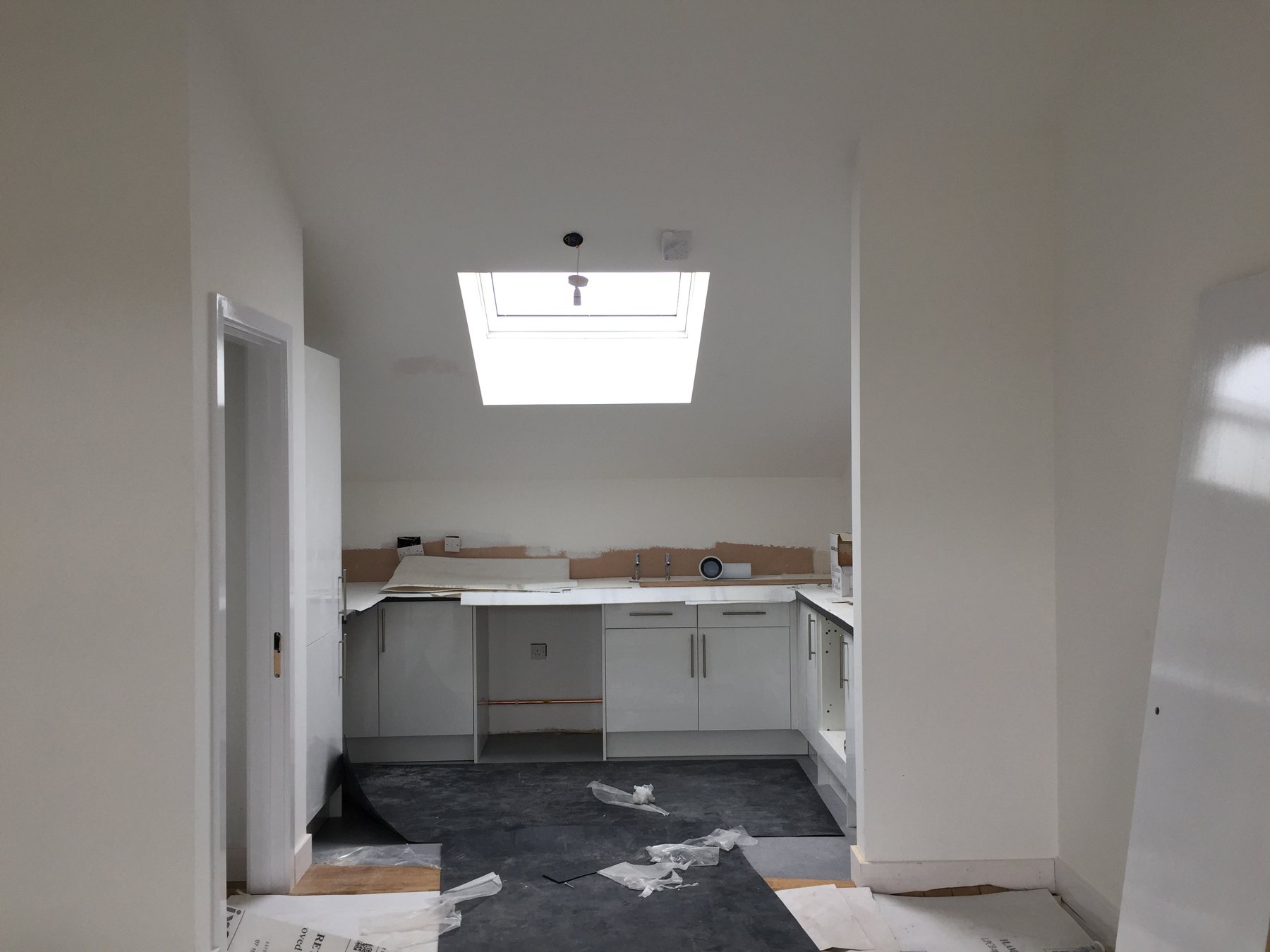

A finished kitchen
Kitchens

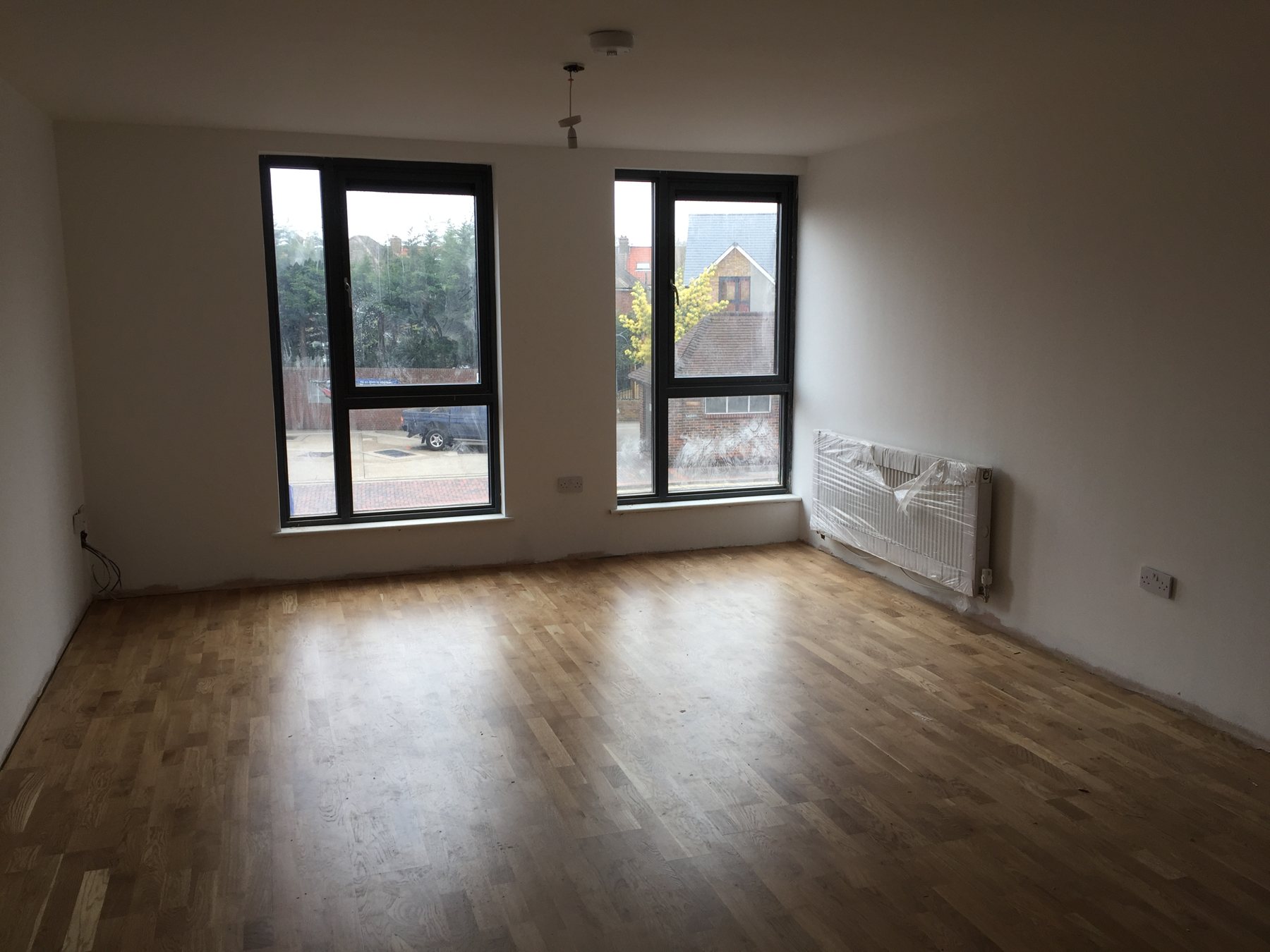

A finished living room with views
Living spaces

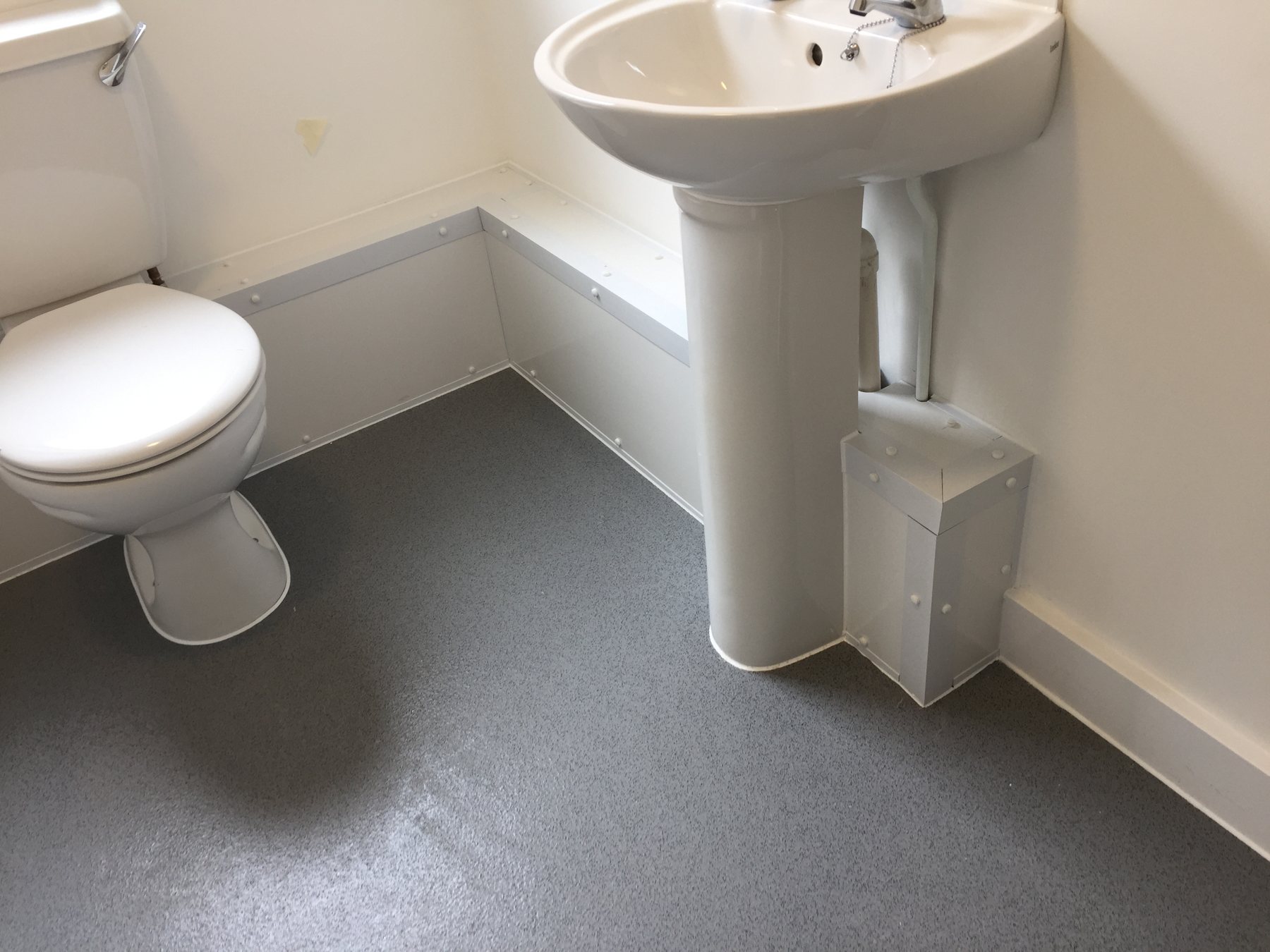

A finished bathroom
Bathrooms

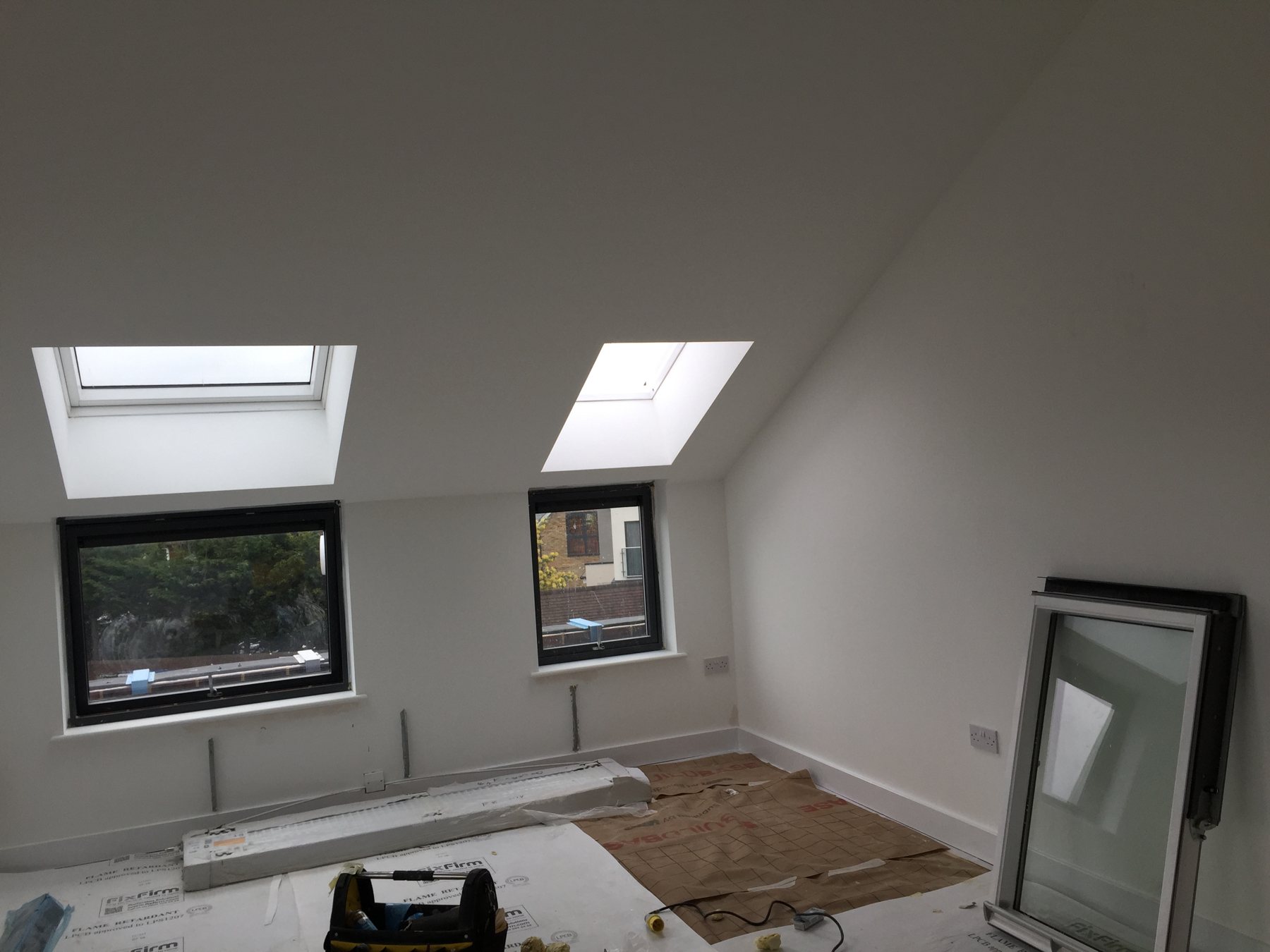

A finished room with rooflight
Light-filled rooms
The programme

Faster, because two jobs happen at once.

8 weeks

In the factory

Sixteen modules built off site, running in parallel with our groundworks.

3 days

To install

All sixteen pods delivered by road and craned into position.

8 weeks

To fit out

Internals, services and finishes completed on site, ready to occupy.

Why modular

The case for building off site.

For the right project, modular construction has real advantages over a traditional site build.

01

Speed

Because the factory build runs at the same time as the groundworks, the programme overlaps instead of running end to end. On site, the shell was standing in three days rather than months.

02

Quality and consistency

Modules are built indoors to tight, repeatable tolerances, inspected as they go and never exposed to the weather during construction, so quality is controlled and consistent across every home.

03

Far less disruption

Most of the build happens miles away in a factory. That means dramatically less noise, traffic, dust and time on a tight residential street, which matters to neighbours and planners alike.

04

Programme certainty

Weather delays and trade sequencing on site are largely designed out, so the timeline and cost are more predictable from the start.

05

Less waste

A controlled factory process orders and cuts materials precisely, reducing the waste and over-ordering that a traditional site can generate.

06

Where traditional still wins

Modular suits repeatable layouts and constrained or sensitive sites. For one-off, bespoke homes we still build traditionally for maximum design freedom. We do both, and advise on which fits.

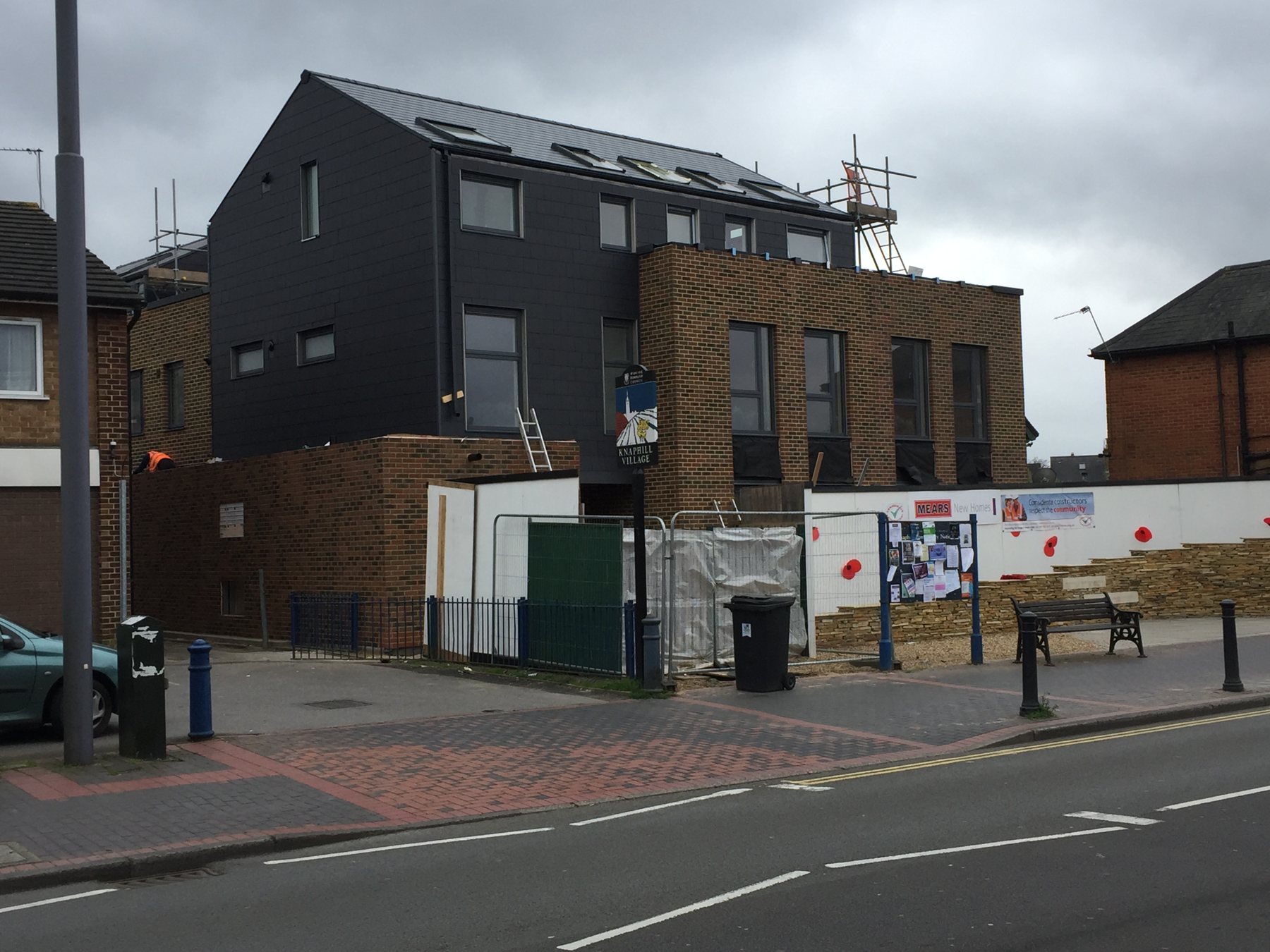

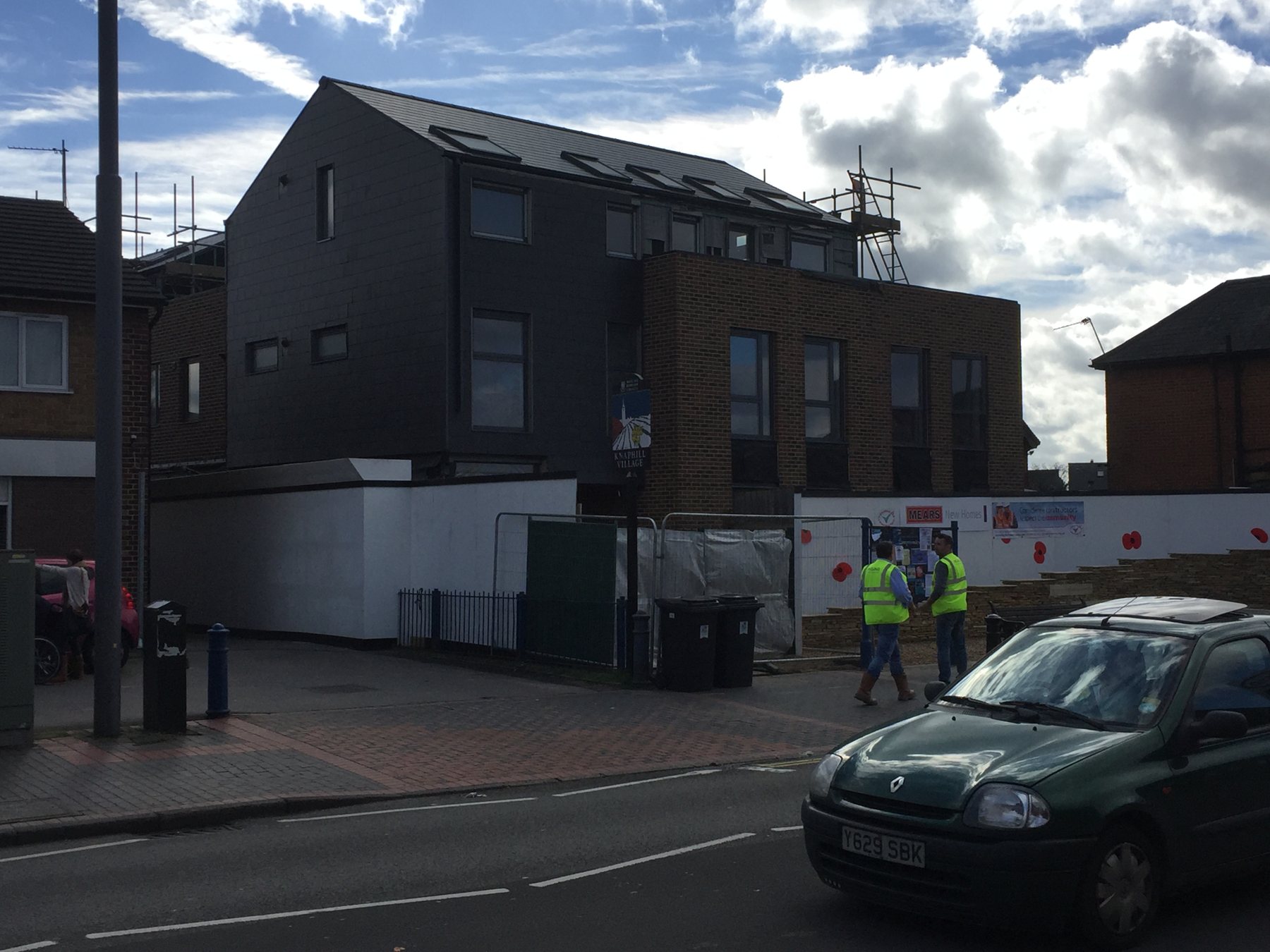

The finished development

Twelve homes on a Surrey street.

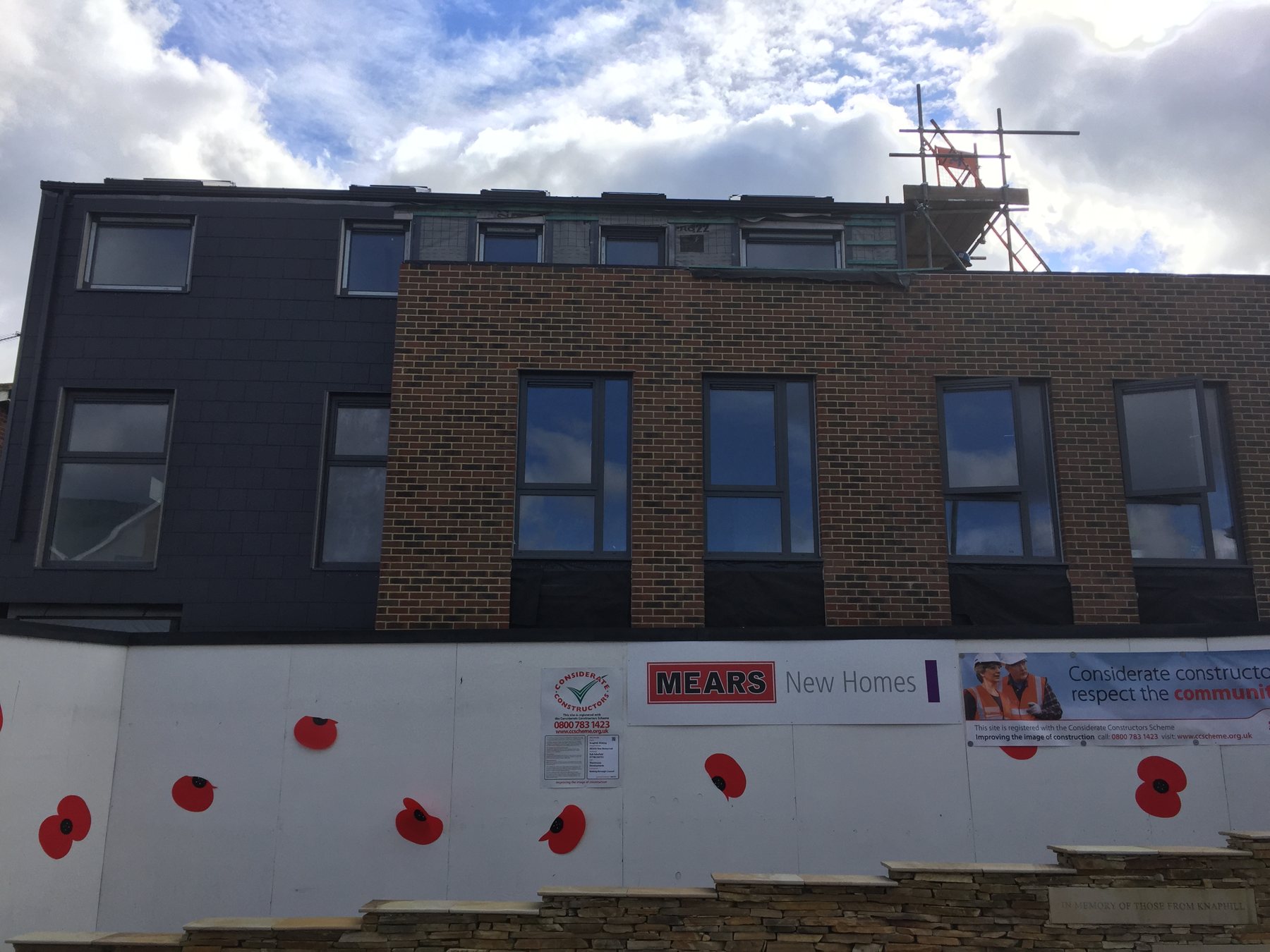

The finished Knaphill development Street view of the finished apartments The team on the module install The completed building behind Mears New Homes hoarding A finished apartment living room A finished apartment kitchen

Manufactured off site, installed and finished by Hankley Homes for Mears.
